In late 2024, Commonwealth Fusion Systems did something no fusion energy company had done before: it secured local government approval to build a fusion power plant with a physical connection to the U.S. electrical grid. The project, sited in Chesterfield County, Virginia, on land leased from Dominion Energy Virginia, is designed around CFS’s ARC commercial reactor concept. If the company can deliver on the physics and the engineering, the plant would feed electricity directly into Dominion’s transmission network, turning a technology that has lived in laboratories for seven decades into a working power source.
As of June 2026, no electrons have flowed. But the permits are real, the utility partnership is real, and the regulatory path is underway. That combination makes this the most concrete step any private fusion venture has taken toward commercial electricity generation.
What Chesterfield County actually approved
On December 17, 2024, Chesterfield County publicly announced that CFS had selected the county for its first fusion energy facility. Under the arrangement, CFS will lease a site from Dominion Energy Virginia, and Dominion will contribute development and technical expertise to support construction and integration of the ARC reactor.
The Chesterfield County Board of Supervisors subsequently approved a conditional-use permit authorizing CFS to build and operate the plant. The permit covers reactor buildings, a switchyard, and an overhead transmission line connecting the facility to Dominion’s existing high-voltage network. A conditional-use permit is a binding land-use decision that requires a public hearing and a formal vote, giving it more institutional weight than a corporate press release or a memorandum of understanding.
The switchyard and transmission line are particularly significant. These are the physical components that tie any power plant to the broader grid. Their inclusion in the permit means the project was designed from the start as a grid-connected generating station, not an isolated research facility. County officials also highlighted expected economic benefits, including new jobs and capital investment, signaling local political support for hosting a first-of-its-kind energy project.
The technology behind the bid
CFS spun out of MIT’s Plasma Science and Fusion Center in 2018 with a specific thesis: that advances in high-temperature superconducting (HTS) magnets could make fusion reactors dramatically smaller, cheaper, and faster to build than previous designs. In September 2021, the company demonstrated a 20-tesla HTS magnet, the most powerful of its kind ever built for a fusion device. The milestone, documented by MIT and covered in Nature, validated the core enabling technology for the company’s approach.

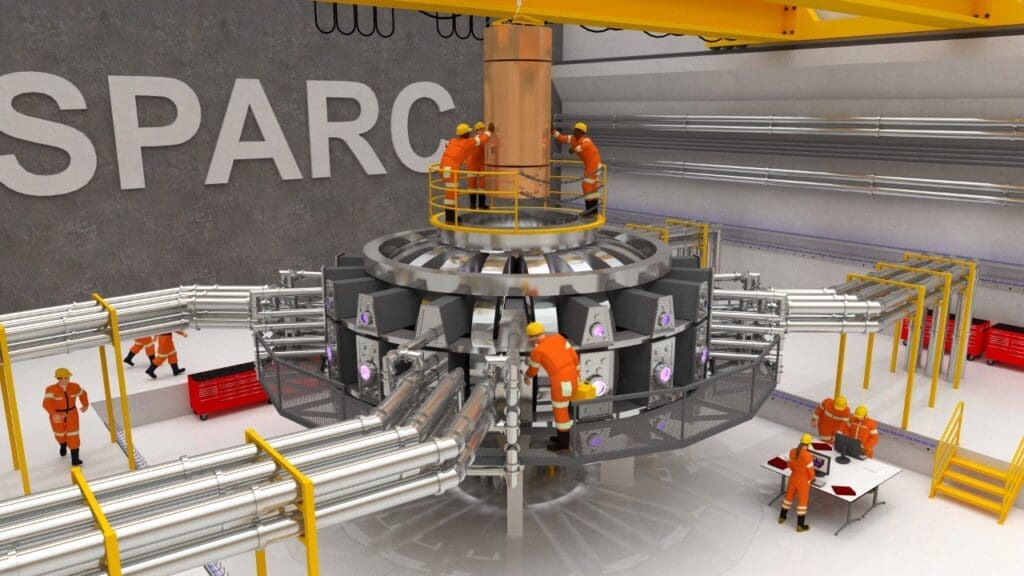

CFS’s development roadmap has two stages. First is SPARC, a compact demonstration tokamak under construction in Devens, Massachusetts. SPARC is designed to achieve a fusion energy gain factor (Q) greater than 2, meaning it would produce more energy from fusion reactions than is pumped in to heat the plasma. If SPARC succeeds, it would be the first privately built device to demonstrate net fusion energy. The ARC reactor planned for Chesterfield is the commercial-scale follow-on, designed to generate electricity for the grid rather than simply prove the physics.
The company has raised more than $2 billion in private funding from investors including Breakthrough Energy Ventures, Google, and Tiger Global Management, making it one of the best-capitalized fusion ventures in the world. That funding level matters because building both SPARC and ARC requires sustained, capital-intensive engineering over many years.
Why Dominion’s involvement matters
Dominion Energy Virginia is one of the largest regulated electric utilities in the eastern United States, serving roughly 2.7 million customers across Virginia and North Carolina. Its willingness to lease land and provide technical expertise to a fusion startup carries weight that a standalone corporate announcement would not.
Regulated utilities operate under intense scrutiny from state public utility commissions and federal regulators. They rarely attach their name and infrastructure to generation technologies they consider purely speculative. Dominion’s participation suggests the company sees enough technical credibility in CFS’s approach to invest staff time and site access, even if the commercial terms of the arrangement have not been publicly disclosed.
What remains unknown is whether Dominion has committed to purchasing electricity from the ARC reactor once it operates. No power-purchase agreement or long-term offtake contract has appeared in public filings. That distinction matters: leasing land and lending expertise is a low-risk way for a utility to gain experience with an emerging technology, while a firm purchase commitment would represent a much deeper financial bet. For now, Dominion appears to be keeping its exposure measured while positioning itself at the front of the line if fusion power proves viable.
The regulatory road ahead
A county conditional-use permit is a necessary step, but it is an early one. Connecting a new generator to the U.S. power grid requires engagement with federal authorities and the regional transmission organization. In Chesterfield County’s case, that means PJM Interconnection, the grid operator managing the mid-Atlantic region, and potentially the Federal Energy Regulatory Commission (FERC).
The county documents confirm that CFS has local permission to build a switchyard and overhead line. They do not specify whether CFS has filed a formal interconnection request with PJM or FERC. PJM’s interconnection queue is publicly searchable, and as of mid-2026, the queue is heavily backlogged with solar, wind, and battery storage projects. How a fusion plant would be studied and prioritized within that queue is an open question, partly because no fusion facility has entered the process before.
Federal regulatory treatment of fusion is itself evolving. The Nuclear Regulatory Commission has historically overseen fission reactors, but fusion devices differ fundamentally: they do not produce long-lived radioactive waste and cannot experience a meltdown in the way fission reactors can. The NRC has been examining how, or whether, fusion should fall under its existing licensing framework. CFS and other fusion developers have advocated for a streamlined regulatory path that reflects fusion’s distinct risk profile. How that debate resolves will shape the timeline and cost of bringing any fusion plant online.
Where CFS fits in the private fusion race
CFS is not the only company chasing commercial fusion, but it is the first to pursue physical grid-connection infrastructure through a local permitting process. The competitive landscape includes several well-funded rivals taking different technical approaches.
Helion Energy, based in Washington state, has signed a power-purchase agreement with Microsoft targeting electricity delivery by 2028. Helion uses a field-reversed configuration rather than a tokamak, and its business model emphasizes direct electricity conversion without a traditional steam turbine. TAE Technologies, based in California, is pursuing a beam-driven field-reversed configuration and has partnered with Google on machine-learning-assisted plasma control.
Internationally, the ITER project in southern France remains the largest fusion experiment ever attempted, but it has faced repeated cost overruns and schedule delays. Originally expected to achieve first plasma in 2025, ITER’s timeline has slipped significantly, and its total cost has ballooned past $20 billion. The contrast between ITER’s government-funded megaproject model and CFS’s venture-backed approach is one of the defining tensions in the fusion world today.
None of these competitors have yet demonstrated net energy gain from a fusion device, and none have secured the kind of local grid-connection permits that CFS now holds in Virginia. That does not guarantee CFS will be first to deliver power, but it does mean the company is further along the infrastructure and permitting path than any peer.
What still has to go right
The distance between a county permit and commercial electricity remains enormous. Several technical and regulatory milestones must be cleared before the Chesterfield plant could deliver power to homes and businesses.
First, SPARC must demonstrate net energy gain. Without that proof of concept, the ARC commercial design lacks a validated physics basis. CFS has not publicly committed to a specific date for SPARC’s first plasma or its Q>1 demonstration, though the company has previously indicated it is targeting operations in the mid-2020s.
Second, the ARC reactor must be engineered, built, and commissioned at a scale that produces electricity reliably and affordably. No public data exists on the plant’s expected output in megawatts, its projected capacity factor, or its anticipated cost per kilowatt-hour. Without those figures, any comparison to natural gas, solar, wind, or nuclear fission remains speculative.
Third, federal interconnection and safety approvals must be secured. The county permit addresses land use, not reactor safety or grid reliability standards. Those reviews will involve different agencies, different technical criteria, and potentially years of study.
Fourth, the economics must work. Even if the physics and engineering succeed, fusion will need to compete on price with increasingly cheap renewables, battery storage, and natural gas. Whether fusion can offer something those sources cannot, such as firm, carbon-free baseload power without the waste challenges of fission, will determine its long-term market role.
A real step on an unfinished road
The Chesterfield County approvals represent something genuinely new: a private fusion company moving through the same local permitting process that governs gas plants, solar farms, and substations. CFS and Dominion Energy are preparing grid-connection hardware for a technology that has never produced commercial electricity. That is a meaningful threshold, and it deserves attention.
But permits are not power. The hardest tests, sustaining a fusion reaction that produces net energy, meeting federal safety and interconnection standards, and delivering electricity at a price customers will pay, all lie ahead. What the Chesterfield filings prove is that at least one fusion company and one major utility believe those tests are worth preparing for. Whether they are right is a question the next several years will answer.
